Delay Notes

Dan Stern Updated by Dan Stern

Delay Notes allow you to extend the duration of a task, by adding a set number of days to the existing schedule duration pushing out the completion date.

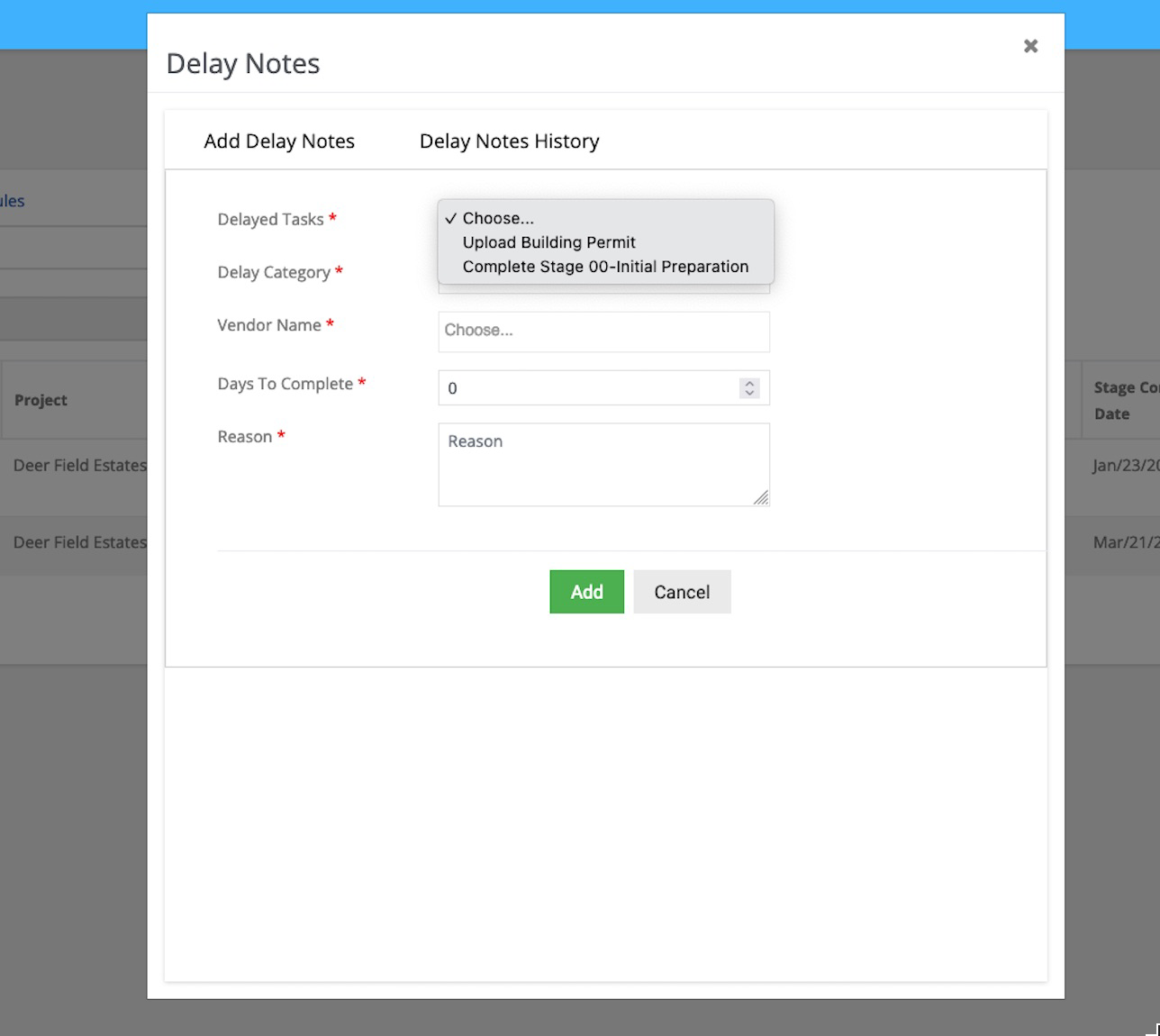

From the task tracker, you can access the delay notes using the thumb down icon.

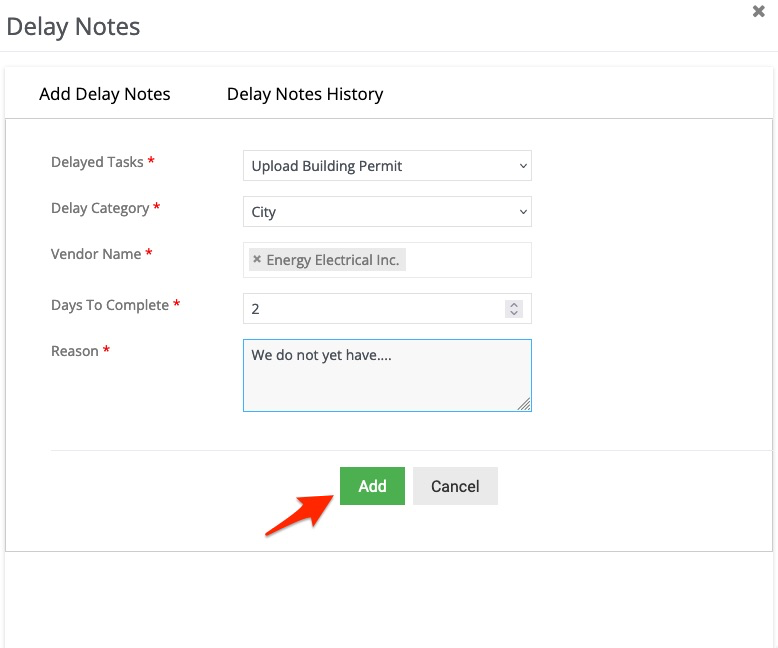

We then complete all fields and specify the days it will now take to complete the stage.

Click add when finished.

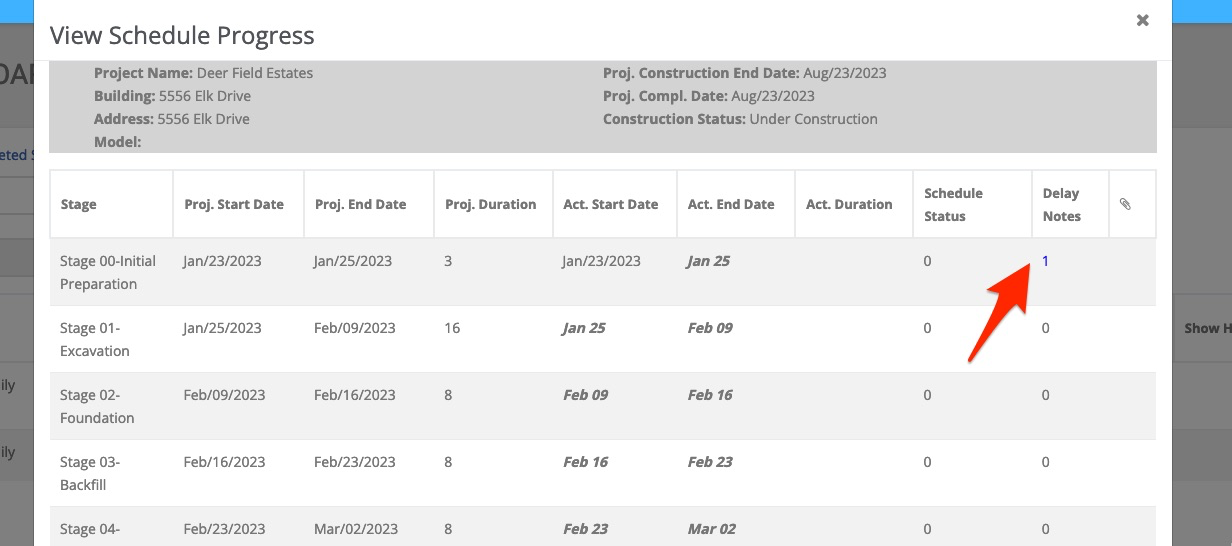

This note will then appear in View Schedule Progress:

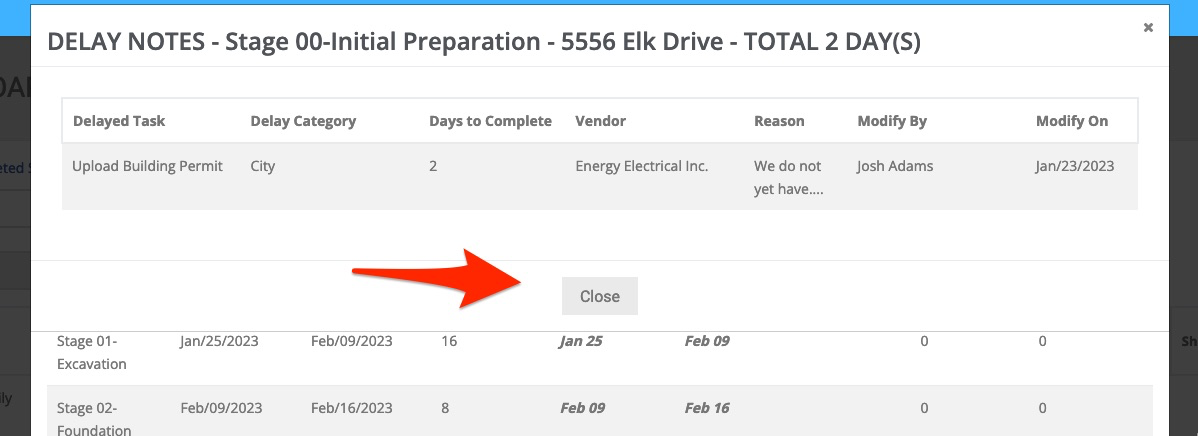

We can view the details about this delay by clicking on the link:
